Marking
Double marking (DM) is the practice of requiring a single candidate script to be scored by more than one Marker. Double marking is optional.

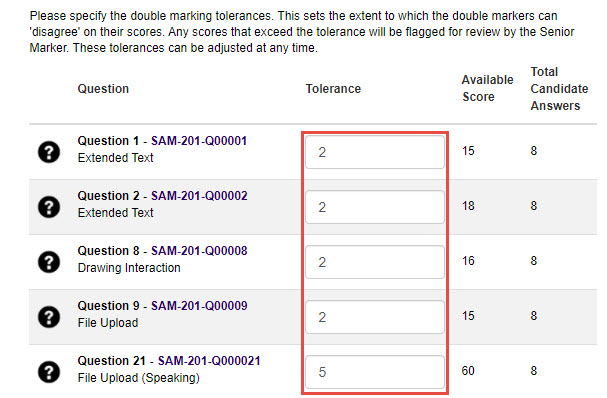

DM settings are expressed as a DM factor, and a tolerance for each question is set.

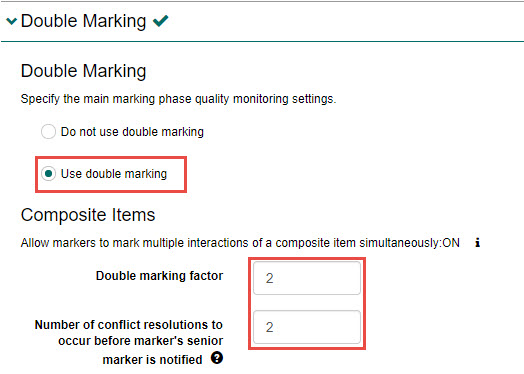

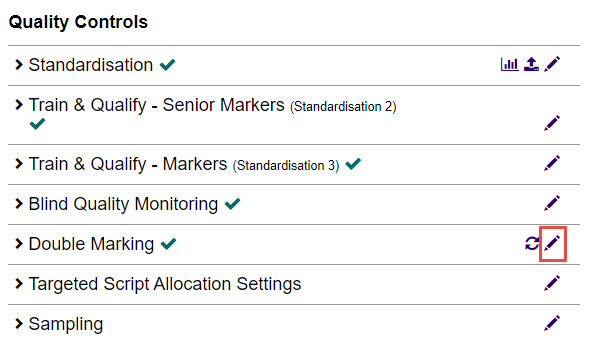

In this section of the Marking Project screen, you can view the current progress which is filterable by marking centres and marking teams. You can also configure double marking.
Complete the following:
Once S3 has been completed, you will need to transition the marking project to marking. This will enable the Markers to commence their marking.
To do this:
